Within the framework of the construction of Nizhnekamsk 495 MW Combined Cycle Power Plant in Tatarstan, the Russian Federation,

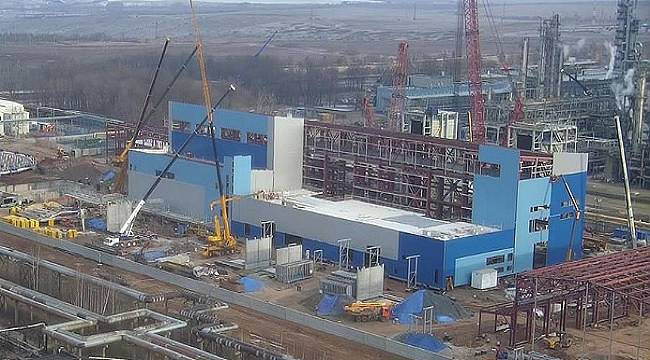

enka has fully completed its mobilization activities and current rate of progress on construction works reached 31.5% as of 31 December 2019.Commodities purchasing is 60% complete. The major site accomplishments of project include installation of 2 x Gas Turbine, 1 x Steam Turbine, 3 x Generators, Condenser and 3 x Step Up Transformers placement on foundation, 2 x HRSGs steel erection and 12 Modules (2,400 tons for 2 HRSGs), 175 tons of underground steel pipe. Construction of major buildings and cooling tower is ongoing. The detail design work of the project is ongoing as well and a progress rate of 80% has been achieved.Energy Economy
